星期一, 9月 27, 2021
Home PV Companies Moss Landing energy storage facility knocked offline after batteries overheat

Moss Landing energy storage facility knocked offline after batteries overheat

The impacted facility went online in December 2020 and features lithium-ion batteries from LG Energy Solution. Fire crews found scorched battery racks and melted wires.

Source:pv magazine

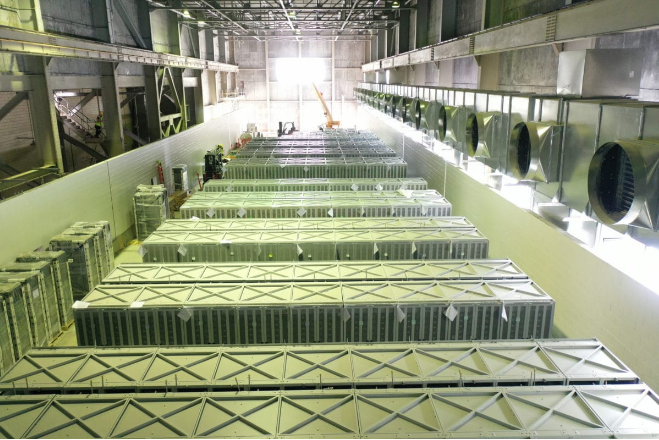

Less than a year after it entered service, the Moss Landing Energy Storage Facility in California was forced offline on September 4 when an unspecified number of batteries overheated.

Local fire crews were called around 8 pm to a reported structure fire, but no fire was found. News reports said that first responders instead found battery racks that had been scorched and wires melted. Fire crews remained on the scene into Sunday.

In a statement, Vistra said that the storage facility experienced “an overheating issue with a limited number of battery modules.” The incident affected the facility’s Phase I 300 MW /1200 MWh system.

Vistra said that risk mitigation and safety systems “worked as designed” and detected that modules were operating at a temperature above operational standards. The company said that targeted sprinkler systems were activated and aimed at the affected modules. Vistra said that the overheating was “controlled and contained” without the need for outside assistance.

Vistra said it would keep the entire facility offline as it investigates the root cause of the incident in partnership with its engineering contractor, Fluence, and battery manufacturer, LG Energy Solution. Vistra was uncertain on the timing of the return of the facility, pending an investigation and any needed repairs.

A spokesperson for Vistra told pv magazine in an email that the company cautioned against insinuating that the batteries caused the incident. “We are very early in our investigation and have not determined a root cause,” the spokesperson said.

The Phase II 100 MW system, which is located in a separate building on site and entered service in August, was not affected by the event. It is currently available for operation.

Fire safety

The 300 MW Moss Landing facility that suffered the battery overheating event entered service in December. The adjacent second phase entered service in mid-August and included 4,500 TR1300 battery racks from LG Energy Solution.

When the second phase entered service, LG said that its lithium-ion-based batteries met fire safety standards, and that its racks had been tested to verify compliance with UL9540A (Standard for Safety Test Method for Evaluating Thermal Runaway Fire Propagation in Battery Energy Storage Systems), to ensure any fire event would not be propagated to adjacent battery racks.

The TR1300’s rack design also meets the American Society of Civil Engineers’ ASCE 7-16, assuring its stable operation even during external environmental changes such as seismic tremors. The standard is now part of the California Building Code.

LG has been working to improve its battery technology since an April 2019 accident involving one of the company’s utility-scale lithium-ion battery arrays at an Arizona Public Service location. A thermal runaway event there caused an accumulation of gases in the container that housed the batteries. Those gases ignited when first responders opened an access door to investigate reports of smoke coming from the container. Two firefighters were seriously injured.

Replacement

In late May, LG Energy Solution said it would replace, at its own cost, lithium-ion battery cells used for certain energy storage products that were manufactured between April 2017 and September 2018. The replacement program came after overheating incidents were reported.

The company said in a statement that it determined that there were issues in the early production processes for electrodes used in potentially affected batteries. Reports said the batteries were produced at the company’s Nanjing factory in China. The replacement program could cost around $350 million.

New batteries will incorporate manufacturing process improvements. The company said it also would implement remote modifications to reduce the potential for overheating while owners wait for their replacement units. LG Energy Solution also will update its battery diagnostic and control software. And it said that field inspections would be undertaken to monitor and minimize the potential for further incidents.

This article was updated on September 7 to clarify that Phase I of the facility entered service in December 2020 and was affected by the overheating incident.

LEAVE A REPLY

Please enter your comment!
Please enter your name here

- Advertisment -

Most Popular

GRIDCO Gets Regulatory Approval to Procure Solar Power at ₹2.75/kWh from a 40 MW Project

The Odisha Energy Regulatory Commission (OERC) has approved the power purchase agreement (PPA) signed between Grid Corporation of Odisha (GRIDCO) and?NHPC Limited?for procuring 40...

Residential Solar System Sizes Continue to Rise in the U.S.: Berkeley Lab

The Berkeley Lab has found that solar photovoltaic (PV) system sizes continue to grow in the United States. In 2020, the median was 6.5...

IREDA’s 10 GW Solar Module Manufacturing Tender Receives Strong Response

The Indian Renewable Energy Development Agency (IREDA)’s tender for setting up manufacturing capacities for vertically-integrated high-efficiency solar modules under the production-linked incentive (PLI) program...

Nanoparticle Paste to Maximize Perovskite Solar Cells’ Efficiency Developed

Researchers at the ITMO University’s School of Physics and Engineering have developed a paste of titanium dioxide and resonant silicon nanoparticles to maximize perovskite...
